What is Panelized Construction? A Practical Look for Builders

Posted by Brandon Trombley on Oct 9, 2025 1:57:30 PM

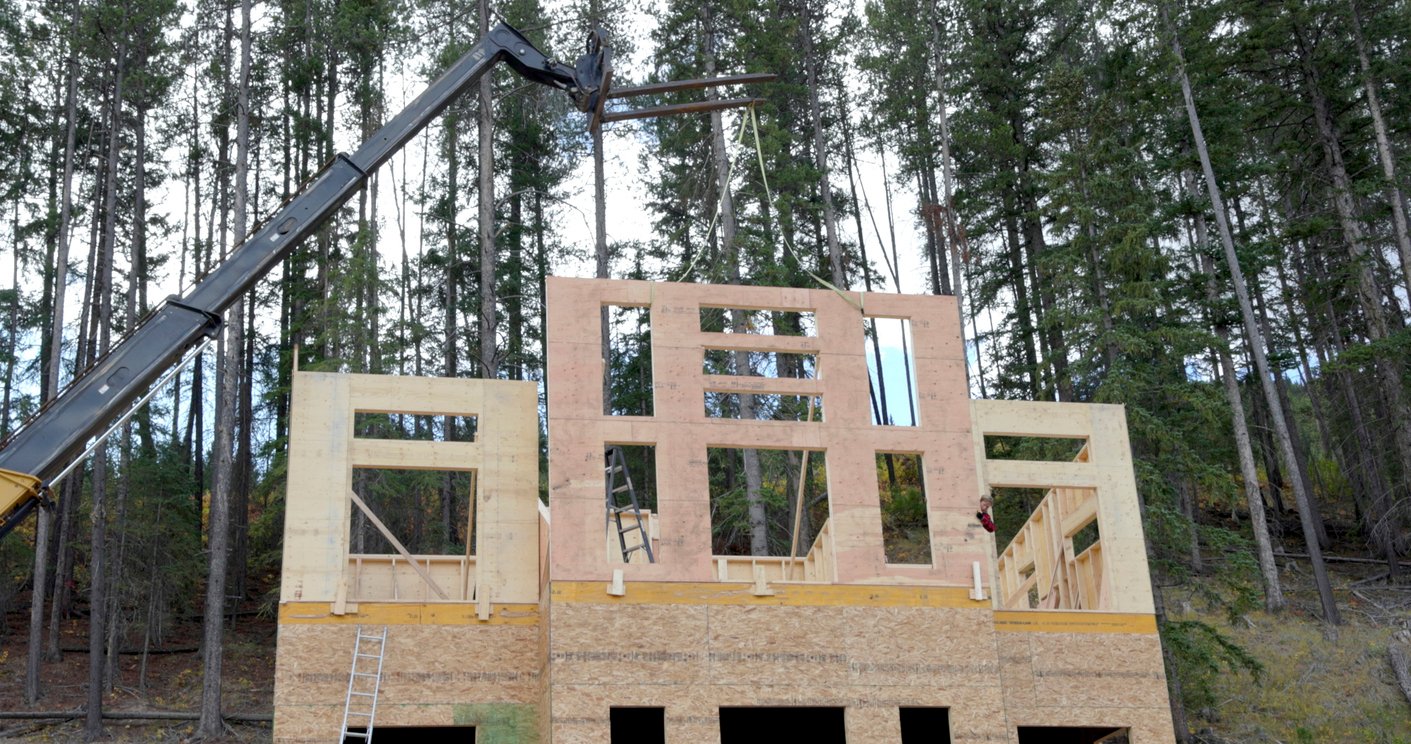

Panelized ConstructionBuilders are under pressure to deliver homes faster without sacrificing quality. Weather delays, unpredictable labor availability, and rising material costs make that difficult when every step is handled on site.

Panelized construction offers a different approach. In this system, structural wall, roof, and floor panels are manufactured in a controlled facility with precision equipment. Panels are delivered ready for assembly, often reducing framing time and cutting material waste.

The method does bring requirements:

  • Design decisions must be finalized earlier

  • Panel deliveries coordinated with cranes and trades

  • On-site flexibility is limited once fabrication begins

This guide explains what panelized construction is, how it works in practice, and what builders should weigh before choosing it.

The Basics of Panelized Home Building

Panelized construction shifts much of the framing process off site.

Structural components are fabricated in a controlled facility, cut to exact specifications, and shipped flat to the job site. Panels often include framing, sheathing, insulation, and rough openings for windows, doors, and utilities.

Method

How It’s Built

Delivery Format

Big Differences

Stick-Built

Lumber cut and assembled entirely on site

Raw materials

Most flexible but labor-intensive, weather delays

Modular

Fully finished 3D modules built in a factory

Large volumetric modules

Faster setup but limited customization

Manufactured

Built to HUD code, delivered on a steel chassis

Completed units

Restricted by federal standards

✅Panelized

Walls, floors, and roof sections pre-assembled

Flat-pack panels

Faster framing, requires early design decisions



Five Steps in the Panelized Construction Process

Panelized construction follows a sequence that blends off-site manufacturing with on-site assembly. Each stage has its own technical requirements that affect schedule, cost, and quality.

  1. Design and engineering

  2. Factory fabrication

  3. Transportation and delivery

  4. On-site assembly

  5. Trade handoff

1. Design and Engineering

Plans must be finalized earlier than in stick-built projects. Structural loads, mechanical chases, and rough openings are locked before fabrication begins, leaving less room for late-stage adjustments.

Most manufacturers use CAD and BIM software to produce shop drawings and generate precise panel specifications. These tools also help identify conflicts – like duct runs overlapping with framing – before work reaches the factory floor.

2. Factory Fabrication

Wall, floor, and roof sections are cut with CNC saws and assembled with automated fastening systems. Panels often arrive with sheathing, insulation, and pre-framed openings for windows and doors.

Dimensional tolerances are typically within ±1/16 inch, tighter than most field-built framing. This precision reduces rework and simplifies the installation of downstream components.

3. Transportation and Delivery

Panels are stacked flat and shipped by truck, with each load sized for equipment handling on site. Deliveries must align with staging space and crew schedules to avoid downtime.

Weather protection is important to prevent sheathing or insulation damage.

4. On-Site Assembly

Panels are unloaded, staged, and set in sequence. Wall sections are braced and anchored to the foundation, followed by floor systems and roof structures.

When logistics align, crews can frame a 2,000 sq. ft. home in three to five days. In a stick-built approach, the same structure might take two to three weeks.

5. Trade Handoff

With the shell complete, mechanical, electrical, and plumbing contractors take over. Pre-planned chases and openings guide installation and reduce conflicts between trades.

From this point forward, construction looks familiar – exterior cladding, interior walls, and finishes follow the same order as conventional builds. The difference is that trades are starting from a more accurate and consistent structure.

The Pros and Cons of Panelized Construction

Panelized construction affects more than framing speed. It shapes schedules, costs, quality control, and the timing of design decisions. Builders need to weigh both what the system delivers and what it demands.

Speed and Efficiency Gains

Panelized systems can shorten framing schedules, but only under the right conditions.

  • Pro: Homes that might take weeks to frame on site can often be completed in days.

  • Pro: Faster shell completion reduces exposure to weather-related delays.

  • Con: Any lapse in site readiness – such as incomplete foundations or delayed deliveries – erases the efficiency advantage.

Quality Control Advantages

Factory production brings a level of precision that’s difficult to replicate in the field.

  • Pro: CNC cutting and jigs produce consistent dimensions, improving fit for structural connections and finish components.

  • Pro: Reduced on-site variability lowers the chance of rework later in the build.

  • Con: These advantages are only realized if the foundation matches spec; even small deviations can cause placement issues.

Cost Implications

Panelized home building redistributes costs rather than eliminating them.

  • Pro: On-site labor hours are reduced, and disposal costs often drop due to lower waste.

  • Pro: More predictable schedules can minimize carrying costs and financing risk.

  • Con: Added expenses for transportation, staging, and equipment can offset labor savings if not budgeted accurately.

Logistics Requirements

Successful panelized projects depend on well-planned logistics.

  • Pro: Sequenced deliveries allow crews to maintain a steady pace once assembly begins.

  • Pro: Faster enclosure means interior trades can mobilize sooner.

  • Con: Sites must accommodate multiple truckloads, and limited space can create bottlenecks.

  • Con: Panels require weather protection during staging to prevent damage.

Design Constraints

Design flexibility is more limited once panels are in production.

  • Pro: Pre-planned openings and chases streamline installation for MEP contractors.

  • Con: Client-driven changes late in the process are costly and time-consuming to implement.

What Builders Should Ask Before Choosing Panelized Construction

Before committing to a panelized system, builders should step back and evaluate whether the method suits their project conditions. These questions help frame that decision.

Does the Project Timeline Benefit From Faster Framing?

If shaving weeks off framing doesn’t impact overall delivery, the time savings may not justify the method.

Is the Design Locked In?

Panel fabrication requires early decisions. Layouts and structural details must be finalized before production to avoid costly changes.

Do the Site Conditions and Economics Work?

Panelized home construction requires both physical space and financial alignment. Sites need room to unload and stage multiple truckloads of panels safely. Budgets must also account for costs like transportation and equipment.

Panelized Construction for Today’s Builders

When builders ask what panelized construction is, the answer is straightforward: it’s a method that can save time, reduce waste, and improve accuracy when properly planned.

It isn’t right for every project. Sites with limited access or designs that demand constant changes may not benefit from the system.

What matters is understanding what is panelized construction in practical terms – its process, logistics, and constraints – before deciding. With that knowledge, builders can evaluate whether this approach matches the needs of their next project.

Ready to Learn More About Panelized Home Construction?

For builders who want a deeper look at how panelized systems work in real-world projects, download our Custom Home Building Guide and see how the process comes together step by step.

Custom Home Building Guide: Panelized Home Construction & Building the Barden Way - Learn More

Topics: Panelized Construction
